Verifying a Radiation Alarm: State Which Part of the Chain Was Tested
Updated 11 October 2026
Map the detector, alarm logic, local indication and remote path. An alarm test is meaningful only when its exercised scope and acceptance basis are clear.

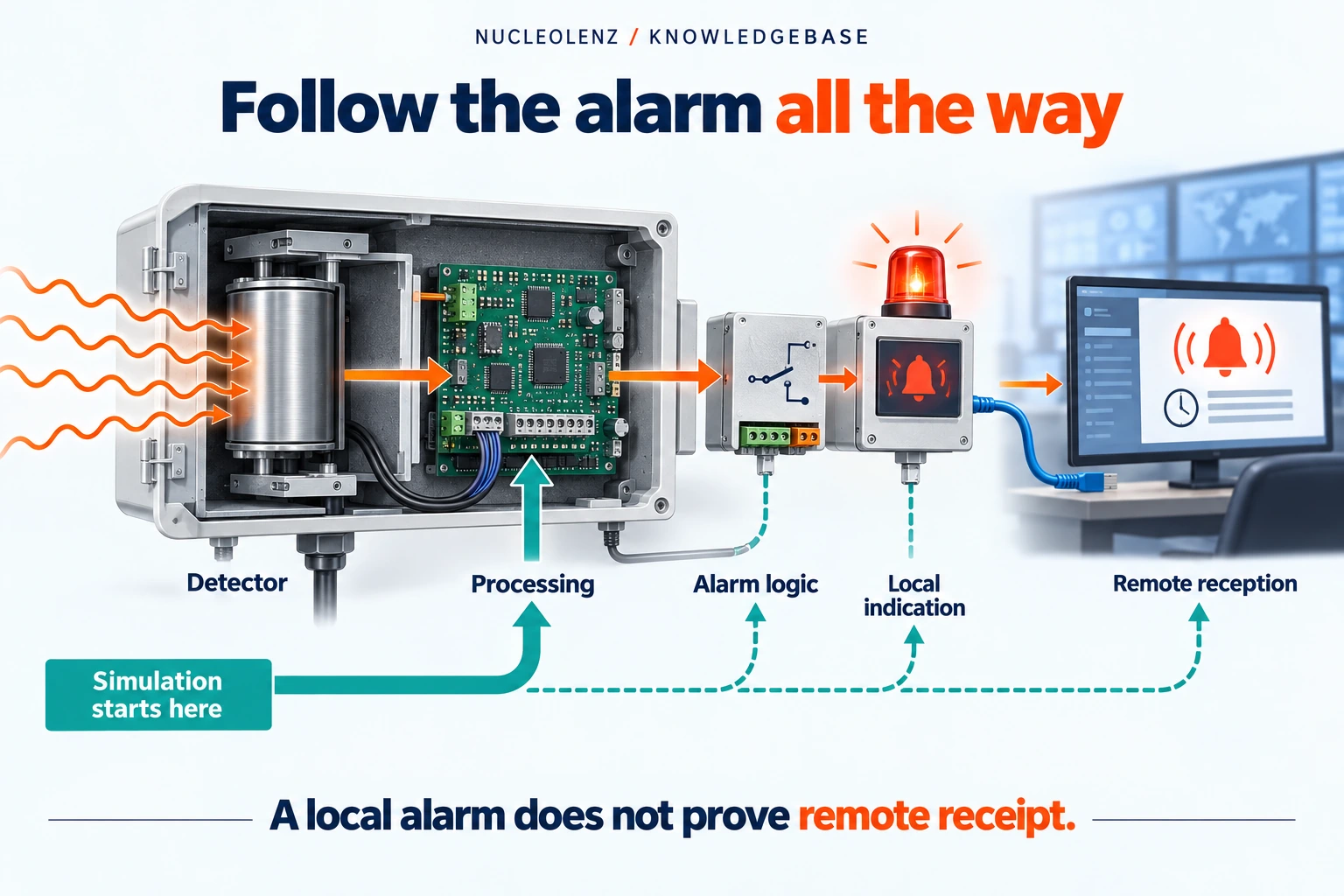

Open the concept graphic at full size ↗
Three key ideas
Show which parts of the alarm chain were tested
- Input: Radiation response or a defined simulation?
- Indication: Which logic and local outputs were observed?
- Reception: Did the intended receiving system get valid information?
At a glance
Which part of the alarm chain was checked?
| Review point | Evidence to look for | What it does not establish |
|---|---|---|
| Source response | Defined detector response observation | Every downstream communication function |
| Simulation | Specified logic and outputs exercised | Detector response to radiation |
| Local indication | Observed display, sounder or light function | Correct remote receipt |
| Operational restoration | Confirmed final configuration and status | Closure from a successful test signal alone |
Use the applicable instrument documentation and the approved site programme for operational decisions.
An alarm test may exercise the detector's radiation response, alarm logic, local sounder, relay or complete receiving system. The statement “the alarm was tested” leaves that scope unclear. Name the parts exercised and the observations recorded so that a demonstration of one function is not mistaken for verification of the whole monitoring chain.
Map the chain before defining the test
Draw the detector, signal processing, alarm decision, local indication and any external outputs or receiving systems. Mark the functions present in the supplied configuration and those needed by the site. A simple diagram is enough to show the test boundaries. Hearing a sound beside the instrument and receiving a recorded message at the responsible control point verify different parts of the system.
Distinguish simulation from radiation response
An approved electrical or software simulation may exercise selected logic or outputs without testing the detector's response to radiation. A source response check may show continuing detector response without verifying every external interface. Both can be useful when their purposes are clear. Neither should be described as a complete end-to-end test unless the method and observations actually support that scope.
Any source-based activity needs the authorized equipment, competent personnel and protection arrangements. A general explanation should not become improvised source-placement instructions or a reason to bypass operational controls. The manufacturer's method and site test plan determine how a verification activity is carried out.
Define the observation and the criterion
For each test objective, record the expected behavior and how the result will be judged. Then keep the actual observation, including timestamps, messages and relevant status where the method calls for them. A result and an acceptance decision are different fields: the first describes what happened; the second explains whether it met the requirement. Document unavailable functions or deviations rather than replacing them with a broad pass statement.
Example: a local sounder demonstration
A fictional commissioning video shows a local sounder operating when the instrument's approved test function is selected. The video is useful evidence of that local function under the demonstrated conditions. It does not establish that radiation reached the detector, that a configured relay changed correctly or that a remote operator received a valid message. The review should name these untested parts and link any additional evidence needed for the project's requirement.
Where separate teams are responsible for the instrument and receiving system, ask each to mark its test boundary and agree on interface verification. This prevents different interpretations of “alarm test” from leaving a gap between the teams.
Record the supplied arrangement
Nucleolenz's Indoor Area Gamma Monitor includes documented local and interface functions. A project-specific test plan should identify the functions actually supplied and connected. The public description is not a commissioning result. Include the instrument identity, configuration, method, acceptance basis, observations and responsible reviewer in the test record.
Establish the final operational state
After the approved activity, confirm the correct operational configuration and status through the responsible process. Retain any required restoration evidence and outstanding follow-up. A successful test does not justify leaving a temporary configuration in place or closing an unexplained observation. The record must show an independent reviewer what was tested, what passed and which required parts still lack evidence.
